The largest natural gas discovery in the Mediterranean, made and brought on stream in record time by combining technology, expertise and the ability to forge solid agreements with the producer country and partner companies.
Zohr can meet local gas needs for decades and at the same time make it possible to build a facility of regional importance for liquefied natural gas (LNG), an increasingly crucial sector for ensuring security of supply. With this project, Egypt confirms its strategic role not only for Eni - it has been strategic for our company since it was founded - but also for the global energy industry.
Country: Egypt
Activity start date: 2017 - present

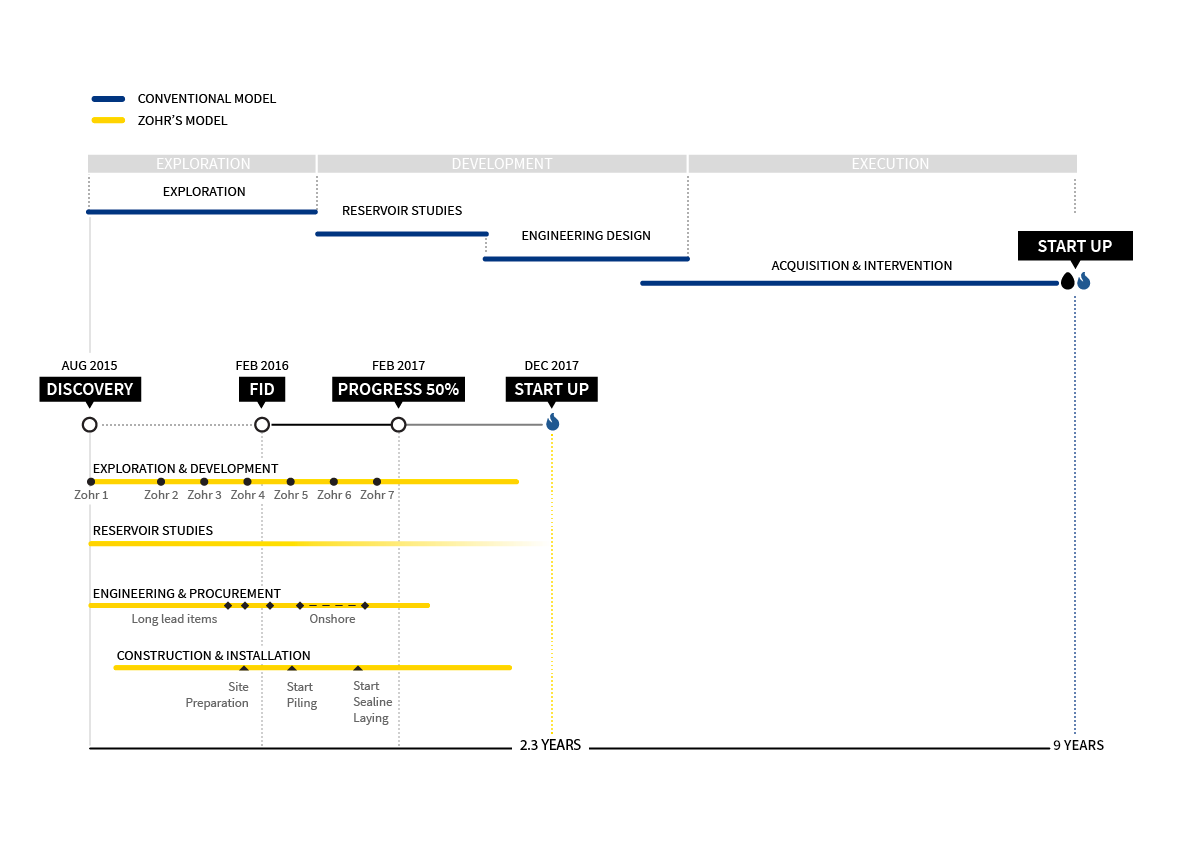

Zohr is a natural gas project offshore Egypt, almost two hundred kilometres north of Port Said in the Shorouk area. The field is a super giant and, as far as natural gas is concerned, it is the largest ever discovered in the Mediterranean. We identified it thanks to our offshore exploration capabilities and studied it in detail using digital geosciences. Using sophisticated algorithms running on our supercomputers Eni geologists were able to reproduce its internal structure in 3D. Its potential turned out to be enormous, enough to meet Egypt's energy consumption for decades and enable the country to establish itself as a major exporter of liquefied natural gas (LNG) in the Mediterranean.
We brought Zohr on stream in less than two years after its discovery, a record time for a deepwater field of this size. This speed is also the result of our Dual Exploration Model, our operating model, which consists of selling minority stakes in newly discovered resources to other players in advance, so as to immediately cash in and thus gain the ability to quickly invest in project development, while still maintaining control and leadership of operations. What makes this approach possible is the technical skills of our people, an example of excellence and credibility for all our international partners.
The Zohr plant
Plant inspection
Onshore natural gas processing plant
Working team
reserves in the Eni field (millions of barrels of oil equivalent)
Find out more about the initiatives we are working on to help achieve a just transition in an inclusive and transparent way.
Dowload the documentThe increase in gas production at the Zohr field has begun with the start-up of the El Gamil compressor station.
Gas production reaches 2.7 billion cubic feet per day
The project is ramped up and gas production reaches 2 billion cubic feet of gas per day
Natural gas production begins less than two and a half years after its discovery
Eni discovers the super giant Zohr field in the Egyptian offshore
A big discovery made with luck, surprises, mistakes and intuition. We don't often think about what happens before discoveries are made, but Zohr is an epic tale.
